December 19, 2025, ©. Leeham News: We do a series about ideas on how the long development times for large airliners can be shortened. New projects talk about cutting development time and reaching certification and production faster than previous projects.
The series will discuss the typical development cycles for an FAA Part 25 aircraft, called a transport category aircraft, and what different ideas there are to reduce the development times.
We will use the Gantt plan in Figure 1 as a base for our discussions. We have concluded the articles about flight tests with the aircraft. Now we revisit the Certification subject and look at how we can show compliance with requirements and work our way to a Type Certificate. We are at the end part of the Testing and Certification phase in our Program Plan in Figure 1.
** Special thanks to Andrew Telesca for helping with this article **
In the last few articles, we’ve shared information on a variety of activities and the associated controls required during the certification project’s implementation phase. This is where the rubber meets the road in showing the regulator(s) – with data – that your design does everything it’s supposed to do, and nothing that it’s not.
If you’ve structured everything in your plans well, resourced appropriately, your suppliers are delivering on time, and you’ve designed for compliance, this phase is all about efficient execution. If not, it’s a nightmare of change control, regression testing, and delays (see: Boeing 777X). The FAA always models it as the longest part of a certification project, Figure 2.
Whether prototype testing, stress analysis, flight testing, or any of the other previously agreed activities needed to satisfy a regulation, each activity requires three distinct efforts to be considered closed:
Substantiating and showing compliance are our responsibility as the applicant. Finding compliance is the responsibility of the regulator and their delegates. Clear communication and coordination between the two parties is essential to avoid delays.
The type certificate cannot be granted until all required findings are completed. As a result, a significant amount of time is spent during this phase conducting meetings between the regulator and the applicant to explain and answer questions about the compliance showings to support approval. If regulators are short-staffed (they usually are), this can be a very slow process.
Each individual activity that is required in this phase can be challenging – the last few articles provide examples of the types and depth of investigation (and associated controls) that are required to substantiate the design.
If we consider that a new aircraft development requires many thousands of such activities to support, resulting in tens of thousands of compliance findings, the complexity of our endeavor comes into view, and with it a fundamental challenge – change management.
As noted previously, the implementation phase is typically long, spanning a couple of years at a minimum. Even if I complete some compliance activities successfully early, what happens when the substantiation of another regulation uncovers an issue, and a design needs to change? Let’s look at a hypothetical example:
You’ve completed 50%+ of your prototype testing. You’ve built your first flight test aircraft and you’ve started to explore the intended service envelope (altitudes, speeds, etc.). Then you have a discovery. You calibrate your air data system and find that, under certain combinations of aircraft orientation, speed, and altitude, the readings are unreliable. After conducting a painful root cause analysis, you have no choice but to move the pitot-static tube. That’s an easy change – you identify a new location, the structural modification is not hard, nor is the updated stress analysis. Except…
The new location requires that you reroute the connection to the pressure transducer, displacing a wire harness. Simple enough to move, except the only place it can go is too close to the harness that includes wiring for a redundant essential system, so due to system separation regulations, that wire in the harness will have to be separated and routed differently.
This results in the redesign of multiple harnesses, updated drawing approvals, and a repeat of multiple analyses. Additionally, the required change impact analysis of those design changes reveals that the harness redesign may have an EMI impact, so the associated testing needs to be repeated and the reports resubmitted for new compliance findings.
Moreover, further testing reveals the new location gives slightly different readings than the old location. This means changes to software parameters, which means changes to software requirements for which the validation and verification have already been completed by the supplier, so new software reviews must be conducted for the new software build. An additional change impact analysis is of course done for any other testing already conducted with the previous software build that may now need to be repeated. Of course, each of these changes that impacted a previous compliance finding must be coordinated with the regulator.
While hypothetical, this example shows the reality of modern aircraft development – each time a change is made during the implementation phase the impacts on today’s highly integrated and coupled design must be assessed. In order to complete the compliance matrix with only correct and applicable compliance findings, we need to ensure that all data is representative of the final type design being presented for certification.
As a result, late changes can not only have ballooning impacts on design, but also on the reams and reams of paperwork that have already been completed. Tracking and controlling these changes is one of the largest challenges of the implementation phase.
One of the few major milestones in this phase that companies often report publicly (at least in the USA) is TIA – the FAA’s authorization for their personnel to get on board the aircraft and begin conducting FAA flight tests.
This is granted after a completed aircraft is presented to the FAA with data showing it is (a) safe enough for FAA personnel to get on board, and (b) sufficiently mature that compliance findings made will be representative of the final production product because the risk of further change is low.
This second part is to reduce the risk of change management mistakes causing missed compliance findings, as well as to preserve regulatory resources so they don’t have to fly the same test points multiple times.
Showing these conditions are met requires the presentation of company flight testing results, as well as a significant amount of equipment, structural testing, and analysis data. It also requires the completion of many software audits, as today’s aircraft software is often the last part of the product to mature. This is typically the last major milestone prior to the granting of the type certificate.

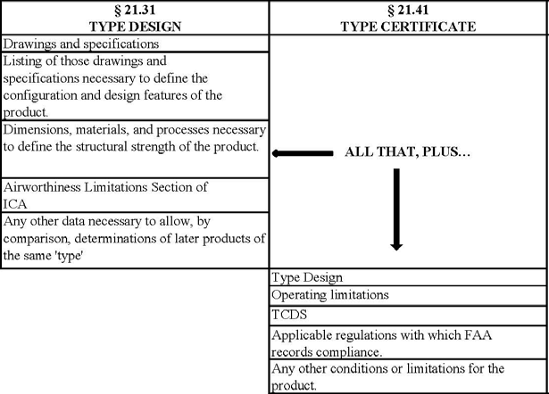

By now, our hybrid aircraft program has pretty much completed the Type Design. We have released a complete set of drawings and specifications along with the required datasets. We can now push forward to obtain the Type Certificate by closing out the Type Certification Board Meeting. In order to close out the Type Certification Board Meeting with the FAA and receive the Type Certificate, all the data comprising the Type Certification must have been presented and compliance found in all areas. Beyond the types of testing and analysis discussed, this also means we need to finalize, based on that data, the allowed usage and limitations of the aircraft’s operation, Figure 3.
These airworthiness and operational limitations are captured in documents such as the Type Certificate Data Sheet, Aircraft Flight Manual, and Instructions for Continued Airworthiness:
Only after these documents are presented for review by the applicant, along with the final version of the Type Design (drawings and specifications) and the compliance matrix (showing all the compliance showings and findings made) can the Type Certificate be granted. Additionally, as the applicant, we must submit a positive statement under 21.20 confirming that the product complies with all applicable regulations. It is both our responsibility and liability to present only a safe, compliant product for certification.
While the earlier phases of the project benefit from a balance of speed and caution to avoid committing resources to a bad design, the implementation phase is all about speed. The design is already set, the plans are in place, so how can we progress through the verification and reporting as quickly as possible?
I have been following this series with great interest. Thank you for writing it. Something I haven’t seen mentioned much is what happens to the process when a truly novel construction method emerges from the manufacturer and there is no previous history for the regulator to use.
The case study for certification of novel construction methods for US based civil aircraft was a little remembered aircraft named the Windecker Eagle. It was the first 100 % composite aircraft the FAA ever had presented to it. This caused a rewrite of the FAAs book on aircraft certification by starting them down the composite path. In 1969, when the Eagle was run thru the cert process, all cert requirements were based on metallic, wood or tube and fabric structures, and the FAA was forced to release new standards to evaluate a structure they had very little expertise with. Ultimately, they got the aircraft approved with few issues with the exception of a prototype loss during spin testing. The aircraft was composed of a fiberglass/foam sandwich and was composed of very large pieces bonded together. European regulators suffered from the same issues when the SSA Diamant, Glasflugel Libelle and Belkow Phoebus sailplanes stretched the regulators ability by outrunning the rulebooks per se.
Today, the LCA certification game still runs into these issues and the result of the builders outrunning the regulations is the generation of “special condition” attachments to the regulations. Many are commonly written today when the regulations lack clarity with regard to novel construction.
I guess that’s a long introduction into Special Condition Letters and I was wondering where they fit in your timeline and hoped you would comment and expand on their use. Thank You
Hi PNWgeek,
We actually briefly discussed Special Conditions, ELOS, etc. in Part 12 of this series when we were examining certification requirements definition.
https://leehamnews.com/2025/10/17/bjorns-corner-faster-aircraft-development-part-12-preliminary-design-requirements-definition/
Henry
In many new aircraft projects you find yourself: Late; over weight; not having promised range and over budget. So you need to work a bit harder before and after certification. Often the medicines are: Detailed analysis to carve out mass, increase fuel load; increase engine thrust; squeeze suppliers to reduce mass and price. All of it requires new reports/testing/FAA-EASA coordination besides asking the financiers for more money. ref. “787 Teerible teens”, Some actually comes after certification as Block updates and some only get solved in the next version i.e. 787-9
Interesting. Bombardier time line from first flight to certification. …d8 400 toronto crews and C series Montreal crews. 2 years. Both far 125. Both clean slate.
400 used 4 come 5 test ac and build line continued while testing.
C series unsure 3 come ? Line stopped after test prototypes built. Did not make that mistake twice.
Anybody come close to that?
Why not you? Why R U so long?
